HYDROCON ENTERPRISE SDN BHD Discuss your project

Kept dry since 1987.

Waterproofing, joints and flooring for the contractors who build Malaysia's landmarks. Applied by our own crews.

0 years on site. CIDB G7, no tender limit. 0 people, all ours.

HYDROCON ENTERPRISE SDN BHD, incorporated 15 June 1987. Registered Grade G7 in building, civil engineering and mechanical works, including B08 waterproofing. Thirty-two staff and seventy-six site workers on our own payroll, so the crew that quotes is the crew that turns up.

Water finds the weak point.

A cold joint, a corner, an upstand, a pipe. Or a crack in a slab that ponds after every storm. Those are the details we draw, build and check.

When the work is done we flood the area and look for leaks before anyone else does.

The system, layer by layer.

Clients ask what actually goes on the slab. This is our RC roof system as we install it, in the order we install it.

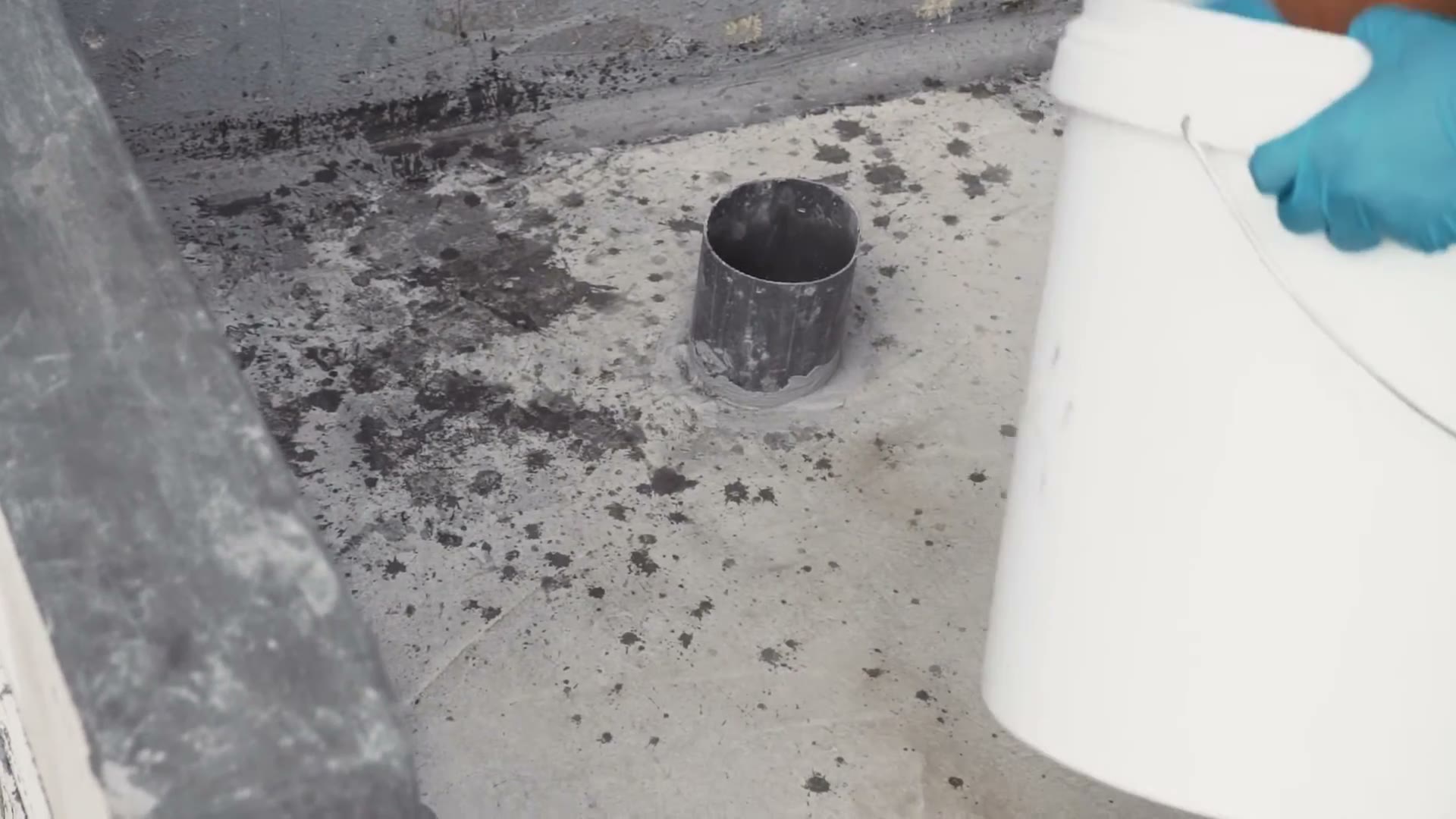

  1. Reinforced concrete slabCleaned, dried and checked for falls.
  2. Base screed to fallCement and sand 1:4, 25 mm average, laid to drain.

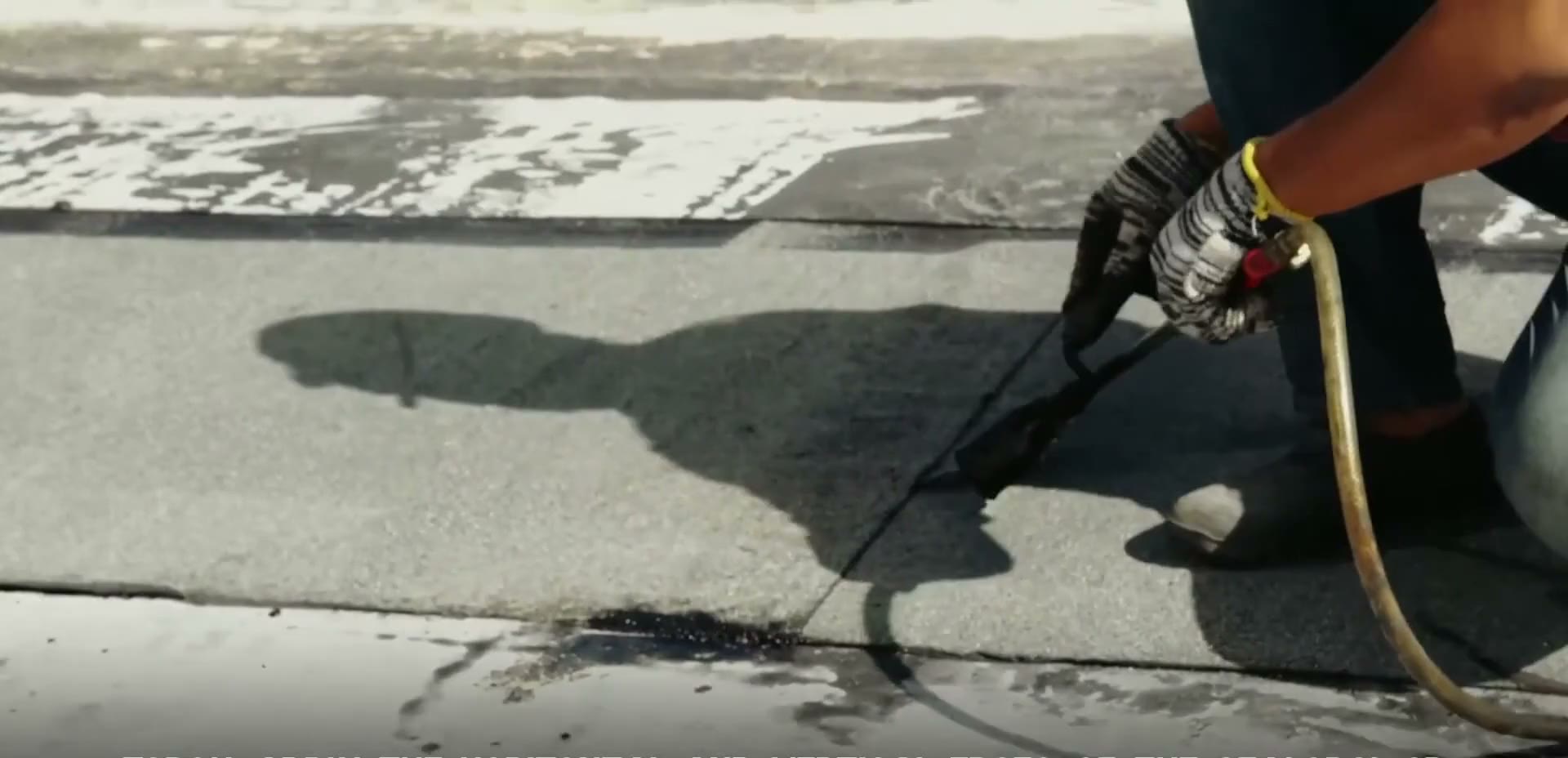

  3. PRIMER W, then CHEMFLEX R-100Three coats of reinforced synthetic rubber membrane, fully bonded.
  4. HYDROFOAM HD insulation50 mm extruded polystyrene board over the membrane.
  5. Polythene sheet500-gauge, between the insulation and the protection concrete.
  6. G25 protection concrete75 mm with BRC A5 mesh, saw-cut into 2 m panels, every cut sealed.
  7. DURACOTE HBTwo coats of polyurethane where the roof stays exposed.
  8. Then we pond test.The roof is flooded and checked before handover.
Cross-section of our RC roof waterproofing system, assembled layer by layer 01 02 03 04 05 06 ISOMETRIC SECTION · NOT TO SCALE build-up

Systems by building zone

Every zone gets its own build-up, drawn layer by layer on the Systems page.

Our crews work across the Klang Valley, Putrajaya, Johor and Penang, and the register runs to Bintulu and Langkawi. Where a specification calls for another manufacturer's system, we apply that.

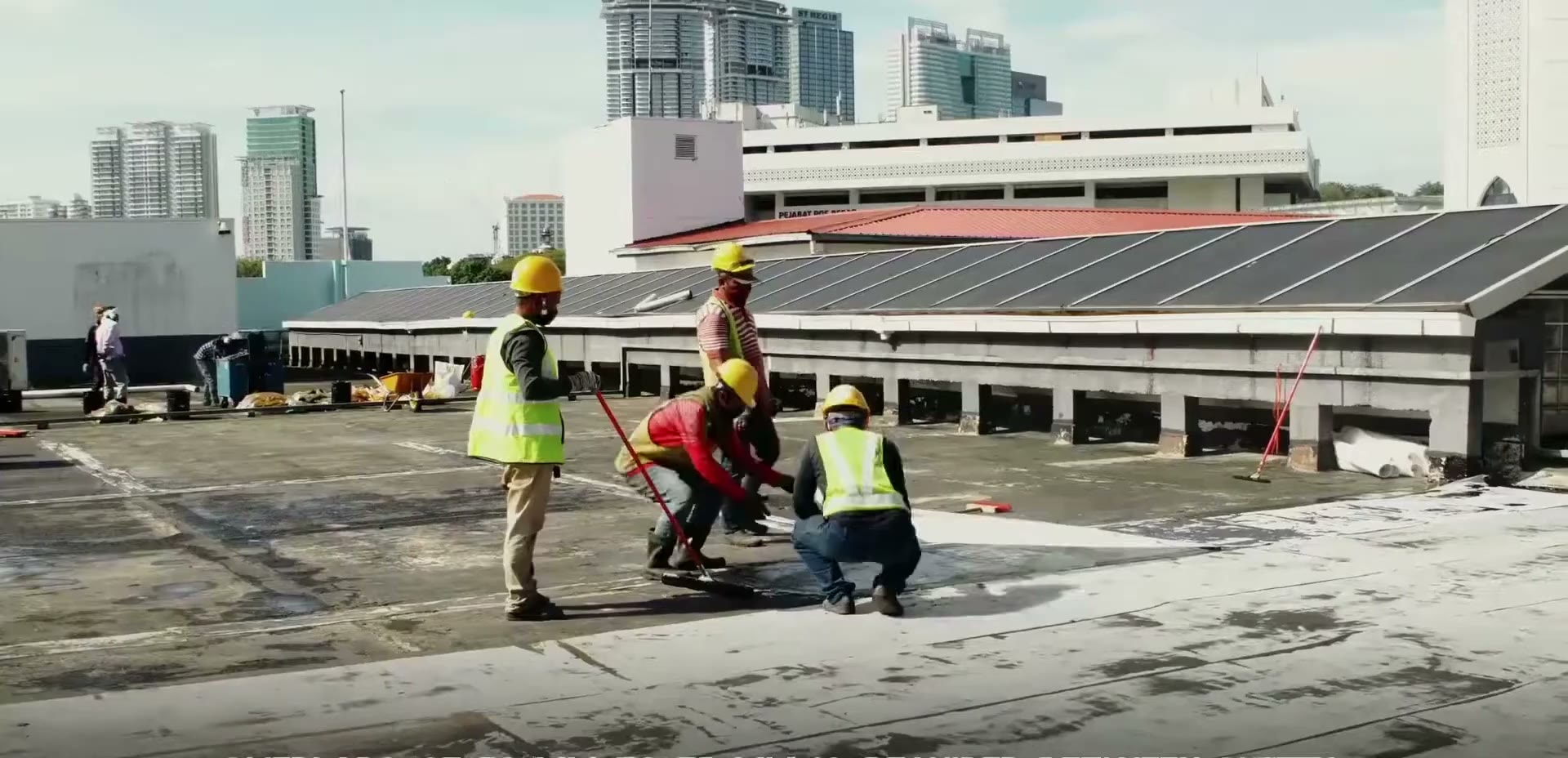

On site

The work, as it happens.

Roofs, joints and wet areas, by our own crews.

The ponding testFlooded and checked before the tiler comes
The angle filletShaped by hand
The joint, bridgedFLEXJOINT EP laid over the movement joint
Protection concretePower-trowelled over the waterproofing system
First coat, rolled onCHEMFLEX R-100 in a toilet
CHEMGROUT 215Mixed for the angle fillet
BRUSHCRETE FX, brushedThree coats, taken up every wall
Cut into panelsProtection concrete is saw-cut so it cracks at a joint, never across

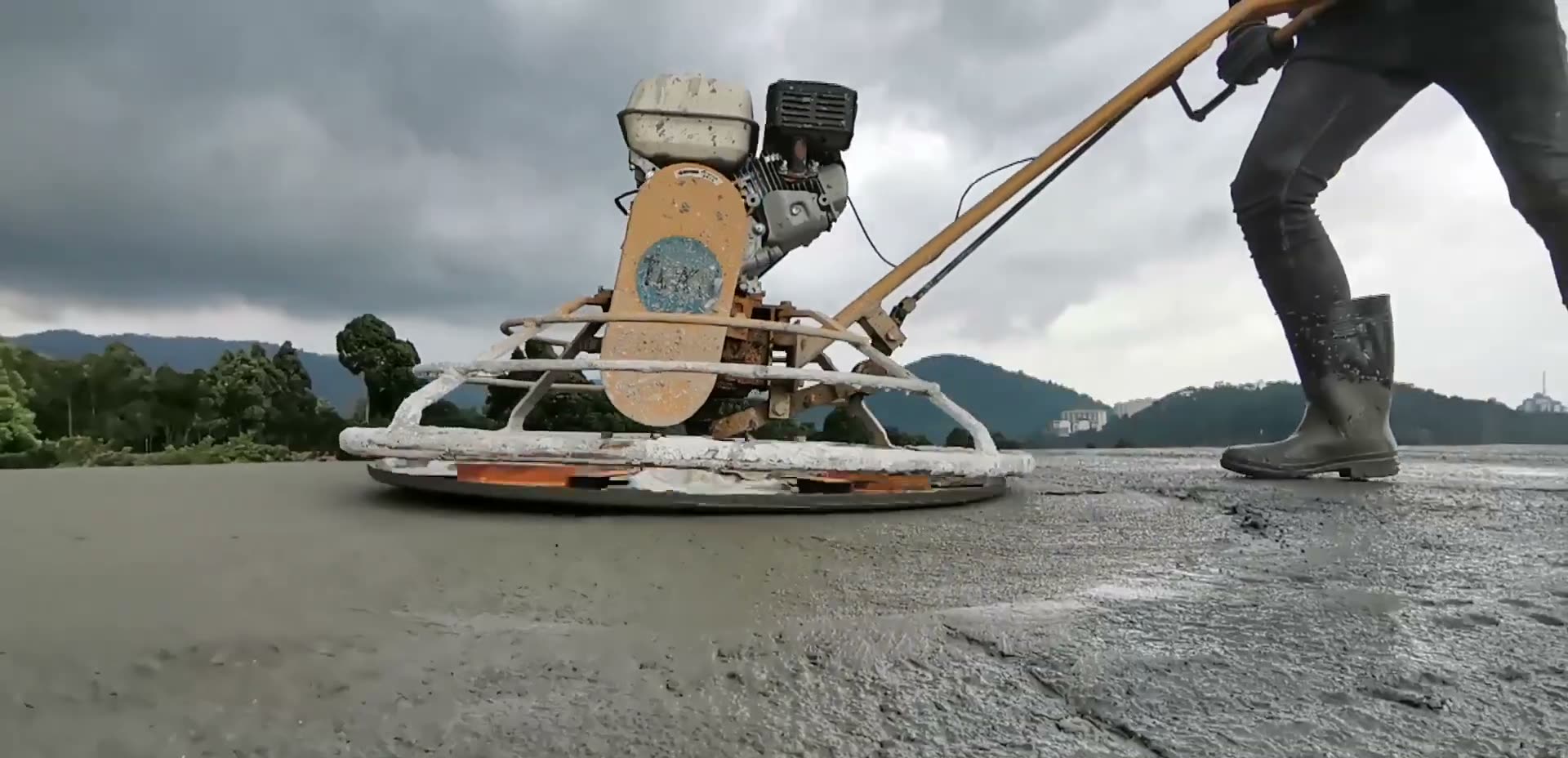

Protection concrete being poured over a waterproofed bungalow roof in Sungai Buloh

Then we concrete over it.

Power-floated level, then cut into panels, so the concrete cracks at a joint and not across the slab.

The waterproofing system underneath never sees the sun again.
